Manage bioprocessing equipment procurement from RFP to installation: specify requirements, qualify vendors, protect lead times, and avoid costly delays.
Bioprocessing equipment procurement is a multi-stage lifecycle that runs from defining requirements and issuing a request for proposal (RFP) through vendor qualification, contracting, and installation. Treating it as a single purchasing event is where most projects fail. Lab managers who run procurement as a structured process protect their budgets, their timelines, and their good manufacturing practice (GMP) compliance long before a bioreactor reaches the loading dock.
Quick take
Bioprocessing equipment procurement is a lifecycle with at least six distinct stages, and most cost and schedule failures are locked in during the first two.
A clear user requirement specification, written before the RFP, is the single highest-leverage document in the entire process.
Vendor qualification is not a formality: in a GMP environment, your supplier's quality system becomes part of your own.
Lead times for capital bioprocessing equipment now stretch from three months to a year or more, so contracts must address delivery, spare parts, and service explicitly.
Procurement does not end at delivery; it closes only when installation and qualification confirm the system performs as specified.
Navigate the bioprocessing equipment procurement lifecycle with our step-by-step guide to smarter, faster lab upgrades.
GEMINI (2026)
Bioprocessing equipment procurement is a lifecycle, not a purchase order
Bioprocessing equipment procurement should be managed as a sequence of dependent stages, not a one-time transaction. Each stage produces a deliverable that the next stage depends on, which means an error early in the process compounds as it moves downstream. A vague specification leads to mismatched bids, a weak contract leads to lead-time surprises, and a rushed qualification leads to audit findings.
The financial stakes make this discipline non-negotiable for lab managers. A single production bioreactor and its supporting systems can represent a six- or seven-figure commitment, and a delayed installation can push back an entire clinical or commercial timeline. The procurement lifecycle mirrors the lifecycle logic that regulators already expect, including the staged approach described in the FDA's lifecycle approach to process validation.
The lab manager's job is to own the connections between these stages, even when other functions own individual steps. Procurement may run the RFP, finance may approve the capital, and quality may sign the qualification, but only the lab manager sees the whole chain. When that ownership is missing, gaps open at the handoffs, and the handoffs are where schedules slip.
Equipment procurement and vendor management are one part of a larger operational picture, covered end to end in this guide to bioprocessing lab operations. The table below reframes the procurement process as a stage-by-stage timeline so lab managers can see where ownership shifts and where delays accumulate.

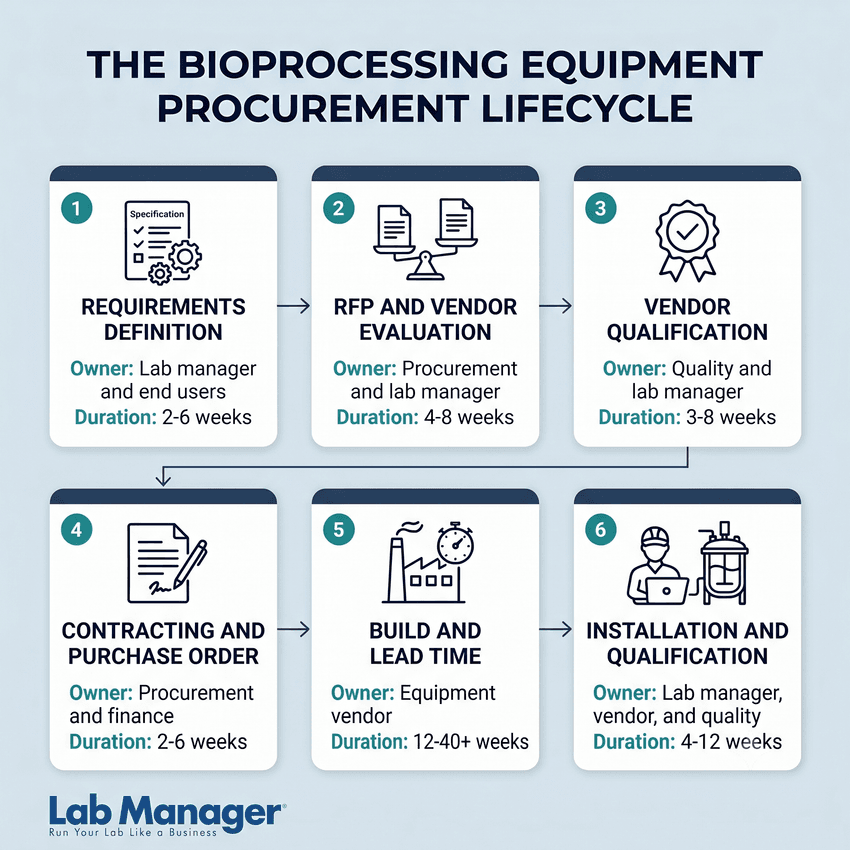

Procurement stage
Primary owner
Key deliverable
Typical duration
Requirements definition
Lab manager and end users
User requirement specification
2 to 6 weeks
RFP and vendor evaluation
Procurement and lab manager
Scored vendor shortlist
4 to 8 weeks
Vendor qualification
Quality and lab manager
Approved vendor record
3 to 8 weeks
Contracting and purchase order
Procurement and finance
Signed contract and purchase order
2 to 6 weeks
Build and lead time
Vendor
Factory acceptance test
12 to 40-plus weeks
Installation and qualification
Lab manager, vendor, and quality
Completed IQ, OQ, and PQ
4 to 12 weeks
Durations are typical planning ranges and vary by equipment class, customization, and vendor backlog.
Defining requirements before the RFP determines everything that follows
The user requirement specification (URS) is the foundation of bioprocessing equipment procurement, and it must be written before any vendor is contacted. The URS translates process needs into measurable, testable requirements: working volume, sterilization method, control system, data integrity capability, and integration with existing utilities. Vendors then respond to your requirements rather than steering you toward their catalog.
Separating genuine needs from preferences is the core discipline at this stage. Needs solve a defined process or compliance problem, while wants improve convenience and can be deferred when budgets tighten. Cross-functional input matters here, because process scientists, quality, facilities, and automation teams each see requirements the others miss.
Writing the URS early also creates a benchmark for every later decision. When a vendor proposes a substitution or a change order, the team can test it against documented requirements instead of relitigating the original intent. That single reference point shortens evaluation and strengthens the lab's position in negotiation.
A strong RFP turns the URS into a document vendors can bid against consistently. At minimum, it should capture:
Functional and performance specifications tied to your process, not vendor marketing language
Documentation deliverables, including validation packages, material certificates, and change-notification commitments
Lead time, delivery, and installation responsibilities, stated as firm obligations
Service, spare-parts availability, and end-of-life support terms
Acceptance criteria for the factory acceptance test (FAT) and site acceptance test (SAT)
Because the RFP carries this much weight, it deserves its own deep dive. For the full structure, including specification templates and scoring methods, see the companion guide on writing a detailed bioreactor request for proposal.
Lab Management Certificate
The Lab Management certificate is more than training—it’s a professional advantage.
Gain critical skills and IACET-approved CEUs that make a measurable difference.
Vendor evaluation and qualification protect quality and the audit trail
Vendor qualification is where bioprocessing equipment procurement crosses from purchasing into quality management. In a GMP environment, a supplier of critical equipment effectively becomes an extension of your own quality system, because their material controls, change management, and documentation feed directly into your validated state. An inspector who finds a gap in your vendor's controls will treat it as a gap in yours.
Evaluation and qualification answer two different questions. Evaluation asks which vendor offers the best technical and commercial fit, scored against the RFP. Qualification asks whether a vendor's quality system can be trusted to supply GMP-critical equipment, and it is supported by audits, documentation review, and risk assessment of the kind described in a peer-reviewed analysis of quality risk management for single-use systems in biologics manufacturing.
Documenting the evaluation matters as much as the decision itself. A scored comparison against the RFP gives the lab a defensible record of why one vendor was chosen, which protects the choice if management or an auditor later questions it. Subjective selections, by contrast, are hard to defend and easy to second-guess.
Interested in lab tools and techniques?
Register for a FREE Lab Manager account to subscribe to our Lab Tools & Techniques Newsletter.
Common warning signs surface during this stage rather than after delivery. Vendors who cannot produce change-notification procedures, who resist site audits, or who quote lead times without contractual backing all signal future risk. The deeper mechanics of supplier audits and approved-vendor records belong to a dedicated treatment of what auditors expect during GMP vendor qualification, and the practical consequences of skipping these steps are captured in a roundtable on the procurement decisions lab managers most regret.
Contracting decisions cover acquisition model, pricing, and service terms
The contract is where bioprocessing equipment procurement either secures the lab's interests or exposes them. Pricing is only one variable; lead-time commitments, spare-parts guarantees, training, and service response times often matter more over the life of the asset. A contract that locks in a low price but leaves service undefined can cost far more when a bioreactor goes down mid-campaign.
Lead-time terms deserve particular scrutiny in the current market. Delivery windows for capital bioprocessing equipment frequently stretch past six months, so contracts should tie delivery dates to defined remedies, name spare-parts stocking commitments, and fix service response times in writing. A purchase order that omits these terms leaves the lab absorbing risk the vendor should share.
The acquisition model is a strategic choice that shapes the lab's balance sheet and flexibility. Buying outright, leasing, and managed or reagent-rental arrangements each distribute capital, risk, and maintenance differently, as summarized below.
Single-use component supply chains need procurement attention of their own
Single-use systems shift part of the procurement burden from one-time capital purchases to a continuous supply relationship, part of the broader move toward flexible, lower-capital facilities described in peer-reviewed work on a single-use strategy for cost-efficient biologics manufacturing. Unlike stainless steel infrastructure, single-use assemblies, bags, and filters must be reordered for every campaign, which makes supply continuity a recurring procurement risk rather than a one-off concern. A qualified backup supplier is not a contingency; it is a core part of the procurement plan.
The fragility of single-source supply became clear when pandemic demand stretched lead times for single-use consumables across the industry. Standardizing component designs and qualifying second sources reduce that exposure. The procurement and quality teams have to coordinate, because a backup supplier only protects you if it is already qualified before the primary source fails.
Treating consumables with the same rigor applied to capital equipment is the differentiator here. The specifics of dual sourcing, qualification sequencing, and inventory strategy are covered in the companion article on qualifying backup suppliers for single-use components.
Installation, commissioning, and qualification close the procurement loop
Bioprocessing equipment procurement is not complete at delivery; it closes only when the system is proven to perform as specified. Installation and commissioning move the equipment from the loading dock to a verified operational state, and qualification documents that verification for regulators. Skipping or compressing this stage to recover schedule is one of the costliest mistakes a lab can make.
The handoff from vendor to lab happens through structured testing. The factory acceptance test confirms performance at the vendor site, the site acceptance test confirms it after delivery, and installation qualification, operational qualification, and performance qualification (IQ, OQ, and PQ) then establish the documented evidence the facility relies on. A practical walkthrough of how to commission new lab equipment maps these stages in detail.
Budgeting realistic time for this stage protects the entire program. Qualification routinely uncovers issues that require vendor return visits, software adjustments, or repeat test runs, and a schedule with no float turns each finding into a delay. Planning four to twelve weeks for installation and qualification, rather than assuming a clean handoff, keeps the timeline honest.
Qualification is also the natural bridge from procurement into ongoing operations. Once IQ, OQ, and PQ are complete, the equipment enters the change-control and maintenance systems that govern its working life, connecting this section hub to the lab's broader GMP compliance and operations programs.
Turning bioprocessing equipment procurement into a repeatable advantage
Bioprocessing equipment procurement rewards labs that treat it as a managed lifecycle rather than a purchase order, because the discipline applied during specification, vendor qualification, and contracting determines whether equipment arrives on time, performs as promised, and survives an audit. The lab manager's role is to keep these stages connected, so that a clear requirement becomes a strong RFP, a strong RFP becomes a qualified vendor, and a qualified vendor becomes equipment that runs. Each spoke article in this section deepens one stage, but the advantage comes from running the full process as one continuous chain.
This content includes text that has been generated with the assistance of AI. For more information, view Lab Manager’s AI use policy.
Add Lab Manager as a preferred Google source to see more of our trusted coverage.
Frequently Asked Questions (FAQs)
What is bioprocessing equipment procurement?
Bioprocessing equipment procurement is the full lifecycle of acquiring major bioprocessing equipment, from defining requirements and issuing an RFP through vendor qualification, contracting, and installation. Managing it as a connected process, rather than a single purchase, is what protects budget, timeline, and compliance.
How does a user requirement specification improve procurement outcomes?
A user requirement specification defines measurable, testable requirements before vendors are contacted, so bids can be compared consistently and acceptance can be verified objectively. It prevents scope drift and gives the lab a defensible basis for accepting or rejecting equipment.
Why is vendor qualification critical in GMP bioprocessing?
In a GMP environment, a critical equipment supplier's quality system feeds directly into your validated state, so a weakness in their controls becomes a weakness in yours. Qualification, through audits and documentation review, gives auditors and the lab confidence that the supplier can be trusted.
When should a lab qualify a backup supplier for single-use components?
A backup supplier should be qualified before the primary source fails, not during a shortage, because qualification itself takes weeks. Building dual sourcing into the procurement plan turns a supply disruption into an inconvenience rather than a stoppage.
